Confined Space Entry and Permit-to-Work
Confined Space Work

Confined Space Entry and Permit-to-Work: When the Risk Changes After Entry Begins

The gas test before entry was clear. It did not show what the residual material would do once disturbed.

9 min read Updated 2026

Most high-hazard permit categories control a hazard that is fixed at the point of issue. The energy is isolated or it is not. The substance is removed or it is not. Confined space entry does not work that way. The atmosphere inside a space can change after the permit is signed and after work has begun – sometimes because of the material already in the space, sometimes because of the work itself. That is what makes this category harder to manage than the permit form alone suggests.

A gas test taken before entry describes the atmosphere at that moment. It does not guarantee the atmosphere will stay that way once work starts. This is the single most important thing to understand about confined space permit management.

Why Confined Space Entry Is a Different Category

In most permit categories, risk is assessed at the point of issue and stays controlled until the job is complete. Confined space entry is the exception. The work being carried out, or the material already inside the space, can alter the atmosphere after entry has begun. A safe gas test at the start does not remain valid for the duration.

That is why continuous monitoring is the central control in confined space work in a way it is not in most other categories. An issuer who treats a confined space permit as a standard permit with an extra gas test step is already running at a lower standard than the task requires. The failure patterns that cut across all permit categories are amplified in confined space work because the consequences of a changing atmosphere are immediate and can leave no time to correct.

A Well-Planned Job Where the Atmosphere Still Changed

A production stoppage at a pharmaceutical manufacturing plant lasted longer than planned. Product inside a blender had thickened and could not be drained in the usual way. A contracted cleaning team was brought in to remove it manually, working inside a confined space containing grain, fermented broth, and water residue, with restricted headroom and a blender ribbon obstructing movement throughout.

The job was planned in sequence before anything was authorised. The known risk was that disturbing the material could release gases, so the sequence was designed to minimise the time anyone spent inside the vessel. Two hatches at either end of the blender allowed most of the material to be removed externally, from the gangway, without entry. Only the residue in the central section – the part that could not be reached from outside – required someone to climb inside. Entry was the last step, not the first.

Case Study – Pharmaceutical Confined Space

Monitors Alarm. Work Stops. System Works.

Everything was in order before entry. The permit was issued. Isolations were verified independently. A gas test inside the blender, taken at three points and three different heights, returned a normal working atmosphere. Each cleaner locked their personal lock onto the LOTO box. The topman (the person stationed at the entry point throughout, responsible for continuous gas monitor watch and communication with the gatehouse, who does not enter the space) was in position before anyone descended.

As soon as the cleaners began disturbing the residual material, the in-vessel gas monitor alarmed. Work stopped immediately. The cleaners moved away from the workface and the alarm was reported. That is the system working as designed.

The residue, having sat in the blender for over 24 hours, had been fermenting and producing gases that displaced the oxygen inside the vessel. The risk was understood before the job started – it was why entry was sequenced as the last step. The gas test before entry showed a safe atmosphere. It did not show what the remaining material would do once disturbed.

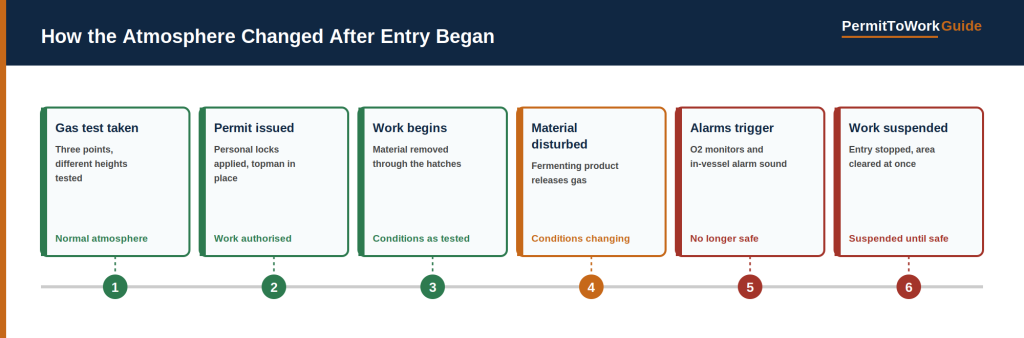

T=0 Gas test Safe reading T+5 MIN Entry begins Permit live T+10 MIN Material disturbed Fermentation gases released T+12 MIN Monitors alarm O2 displacement confirmed Work stopped immediately

The job was planned to minimise entry time and the risk was understood. The monitors caught the change and the system responded correctly.

Work was suspended until the atmosphere returned to safe levels. Extraction was added to draw gases away, and most of the remaining residue was removed through the hatches without further entry. What had been planned as a single shift took three days. The pressure to restart the plant grew with every hour.

Because the risk had been understood before work began, every question from management had a clear, defensible answer. One manager asked whether the job could proceed using breathing apparatus instead of waiting for the atmosphere to clear. That was a genuine suggestion, not obstruction, and it was worth considering on its face. In this case the cleaners were not trained in its use, and the equipment would have restricted their movement inside an already confined and awkward space, adding risk rather than removing it. A different task with a different crew might have made it workable. The point is not to dismiss management suggestions outright – it is to be prepared enough to evaluate them properly, rather than capitulate under pressure or refuse without a reason. The job was completed safely because it was actively managed throughout. The planning before the permit was issued is what made that possible.

Preparation is what allows the issuer to manage pressure from above, rather than be managed by it. An issuer who has fully understood the task going in has a clear, defensible answer ready. One who has not is improvising under time pressure at exactly the wrong moment.

Why the Atmosphere Cannot Be Treated as Fixed

The blender case illustrates a principle that applies to confined space entry generally. The atmosphere inside a space is not a static condition waiting to be confirmed. It can change because of what is already inside the space, because of what the work disturbs, or because of what is being introduced by the task itself.

Welding is the clearest example working in the opposite direction. The hazard is not pre-existing inside the space. It is created by the task. Fumes generated during welding need to be actively extracted away from the vessel and the surrounding area, not simply vented into the same atmosphere being monitored. Venting inside the space transfers the risk rather than removing it. Where welding or other generating tasks are carried out near or within a confined space, coordination with adjacent activities matters as much as the extraction itself. This is examined further in SIMOPS and Permit-to-Work: Where Coordination Fails.

Testing at a Single Point Is Not Sufficient

Different gases have different densities relative to air. A gas heavier than air settles toward the bottom of a vessel. A lighter gas collects near the top. Toxic concentrations have been found at one level of a large vessel while a test taken at a different height showed nothing. A gas test needs to check multiple points and multiple heights inside the space, not a single reading taken at the entry point. Testing only at the entry point is one of the most consistent ways a genuine hazard goes undetected before a permit is issued.

Gas Testing Baseline
  • Test at multiple points and multiple heights inside the space
  • Test before entry and continuously throughout the work
  • Topman monitors continuously, not periodically
  • Any alarm stops work immediately, regardless of task progress
  • Re-entry requires a fresh gas test, not an assumption the space re-cleared

Risk That Enters From Outside the Space

Not every threat to a confined space atmosphere originates inside the vessel. Some of the most difficult risks to anticipate come from separate activity elsewhere on site entirely.

Work inside drains required a standing rule at one site that no vehicles with combustion engines were permitted to run nearby. An idling vehicle produces exhaust gas. That gas can travel through the drain system and reach a confined space workface some distance away, with nobody at either location aware of the connection until the gas monitor alarms. The same principle applied to buildings discharging to drain during the work. Discharges were stopped for the duration, and signed confirmation was taken from each plant area confirming nothing would be released into the drain network while the confined space entry was live.

Neither of those controls appears on the confined space permit itself. They depend entirely on the area authority understanding what else is happening across the site and actively coordinating with those other activities before issuing. A confined space risk assessment that only considers the space itself, without asking what else on site could affect the atmosphere inside it, is incomplete regardless of how well the space itself was assessed.

Signing off a confined space permit without asking what else is live on site that day is a gap. The permit controls the space. The area authority controls the environment around it. Both have to be in hand before entry begins.

Where Confined Space Permits Actually Fail

The most consistent failure is not a missing step on the permit form. It is the assumption that risk assessments and conditions transfer cleanly from one job to another, even when the task is genuinely different.

01

Generic Risk Assessments Reused for Different Tasks

A blender inspection on an empty vessel is a completely different risk profile from a blender clean involving fermenting organic material. Reusing a risk assessment written for one task to cover a different task in the same piece of equipment is one of the clearest ways a confined space permit fails before work even starts. Every risk assessment needs to be specific to the actual task, not the vessel. This specific problem, generic contractor documentation covering the wrong job, is examined in detail in Contractor Management and Permit-to-Work.

02

Continuous Monitoring Interrupted in the Field

Task performers finding a gas monitor’s sample tube physically in the way of the work have been seen to remove it without telling anyone. The issuer believes monitoring is continuous. It has stopped. The equipment is present. The procedure exists. What has failed is the physical reality not matching what the documentation assumed. This is one of the gaps a structured permit system audit is designed to surface — and one reason the topman’s role cannot be a shared responsibility alongside other tasks.

03

Issuer Not Returning to the Workface After Breaks

The expectation is that the permit issuer returns to the workface before the job resumes after any break, not only at the point of issue. Permits have been issued and never revisited before the issuer left site for the day, leaving task performers to restart without anyone confirming conditions were still as expected. The same failure is examined in a broader context in Shift Handover in Permit Systems: What Gets Lost Between Shifts.

04

Scaffold or Equipment Left Inside Before Reinstatement

Scaffold left inside a tank when the agitator was restarted because the final walkdown before reinstatement was never completed. This failure is not unique to confined space work, but the consequences inside a vessel are different from those in open-air plant. The final walkdown before isolation removal is not a procedural formality. It is the last physical confirmation that the space is actually clear before energy is reintroduced.

05

Isolation Labels That Cannot Be Trusted

Two pumps in a switch room with their isolator labels swapped. A label tells you what someone wrote down. It does not tell you what is actually connected. Independent verification of isolation matters more than trusting what is written on the equipment, and this is especially true for confined space work where the consequence of an isolation failure inside the space is immediate and severe. This pattern is examined in depth in Lockout Tagout and Permit-to-Work: Where Isolation Control Fails.

What Properly Run Confined Space Work Actually Requires

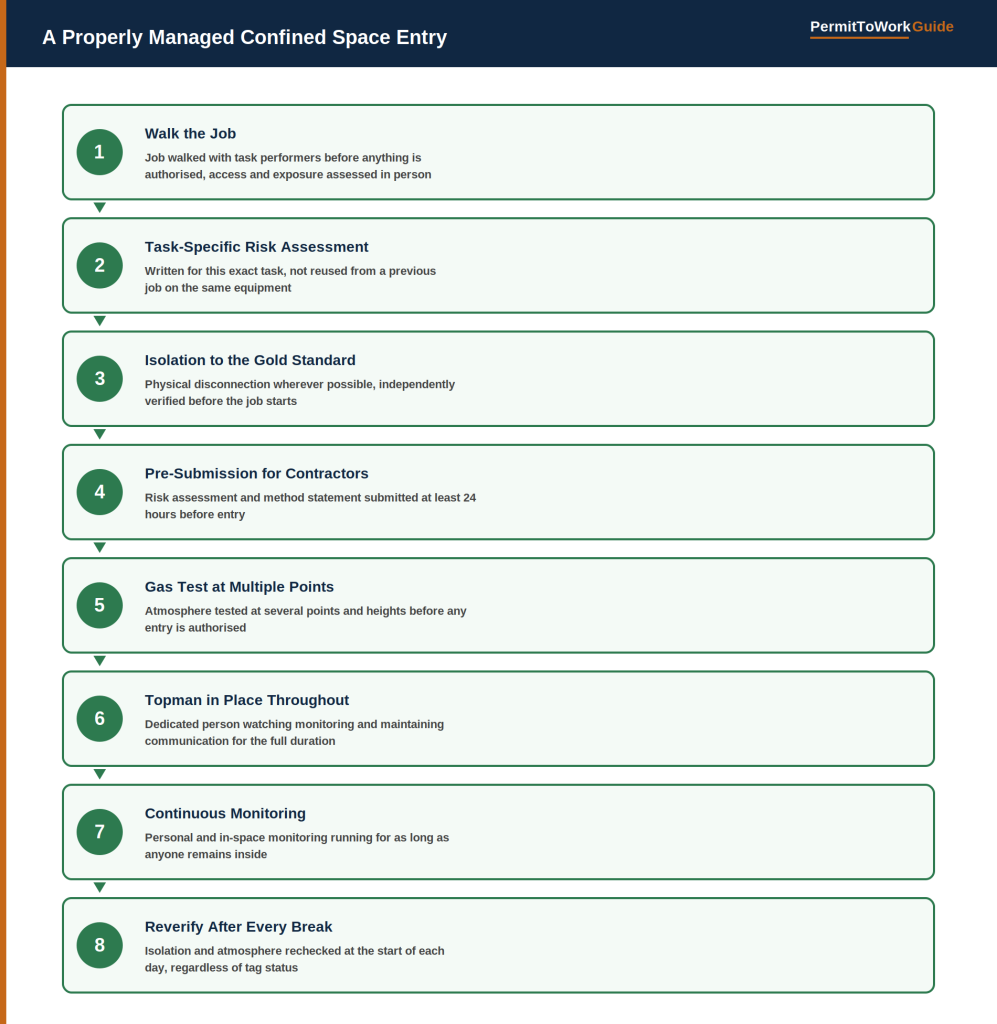

The permit is not the last step in a preparation sequence. It is the document that records the preparation is complete. A well-designed confined space permit has the gas readings on its face, the surrounding area check built in, the topman named, and the LOTO checklist reference recorded – not because those things are paperwork requirements, but because the permit is the integration point. It ties together the job-specific risk assessment, the pre-approved isolation sheet, and the physical controls, and it gives the issuer a single place to confirm everything is in place before anyone enters the space.

Achieving physical disconnection, rather than relying on a closed valve, takes more time than the alternative. Under time pressure, that is exactly the kind of step that gets shortened first. The preparation exists specifically to remove the need to make those decisions hastily once the clock is already running – and the permit is how the issuer proves, to themselves and to anyone who checks, that none of it was skipped.

1
Task-specific risk assessment submitted in advance Not a generic document for the vessel class. Written for this task, this material, this team. Submitted at least 24 hours before work, giving the issuer time to genuinely understand what is being proposed.
2
Physical isolation to gold standard Physical disconnection wherever possible. Fuses removed. Inlets disconnected rather than valved off. Drains locked open – not just clear, but positively locked – so that if someone falls unconscious inside the space there is no route for liquid to accumulate around them. Each isolation independently verified and proven by attempting to operate after isolation.
3
Physical fall protection set up before entry Anchor points fitted at each hatch. Harnesses worn by anyone working near an opening. Where the base of the vessel is uneven or contains residue, boards laid across the base before entry give workers stable footing and significantly reduce the risk of a trip or fall inside the space. A harness on someone who has fallen makes rescue significantly faster, even if they were not clipped at the time of the fall.
4
Gas test at multiple points and heights Three points, three heights. Not a single reading at the entry hatch. Every entrant wearing a personal monitor as a second layer. Results recorded before anyone enters the plane of the vessel.
5
Emergency response headcount confirmed Minimum personnel present before entry could proceed. Where that number dropped, no two confined space jobs could run simultaneously. Emergency response is a go/no-go condition, not an administrative check.
6
Dedicated topman stationed throughout One person assigned specifically to watching the gas monitor continuously and maintaining communication with the gatehouse. Not a shared responsibility. Not someone who also has other tasks during the job.
7
Continuous monitoring throughout the work Not periodic checks. Any alarm stops work immediately and everyone exits. Re-entry only after a fresh gas test confirms the atmosphere has returned to safe levels.
8
Isolations rechecked at the start of every working day For high-severity confined space jobs, isolations were rechecked daily regardless of whether the LOTO tag was still intact. A higher standard than most other permit categories on the same site, applied because the consequence of an isolation failure inside the space justified it.

How the three documents work together in a properly run confined space entry system.

BEFORE ISSUE Job-Specific Risk Assessment Specific to this task and material All control measures identified Pre-approved LOTO sheet referenced Submitted before work begins LOTO / Isolation Sheet Each isolation point documented Method: disconnect, not just valved Independent verification required Pre-approved within the RA both attach to the permit AT POINT OF ISSUE Confined Space Permit Evidences all preparation is complete – the integration point before anyone enters the space ✓ RA attached and reviewed ✓ LOTO checklist ref. and box number recorded ✓ Gas readings recorded on the face of the permit ✓ Surrounding area confirmed clear ✓ Topman named ✓ Emergency response headcount confirmed ✓ Verifier signature confirming controls in place ✓ Issuer satisfied all controls are in place DURING WORK Topman Continuous monitoring throughout Does not leave post during work Any alarm = immediate exit Suspension and Re-entry Any alarm stops work immediately Re-entry needs a fresh gas test Issuer returns before resuming Handback and RTS Space cleared, all personnel out Isolations reversed in sequence Return to Service confirmed

The Practical Standard

A confined space permit that is working properly does two things. It authorises the entry. And it evidences that everything required before entry was actually done – the RA reviewed, the LOTO sheet attached, the gas test recorded, the topman named, the surrounding area checked. If the permit cannot show all of that at the point of issue, the job is not ready.

Beyond issue, the standard is whether the system accounts for conditions changing after entry begins. Continuous monitoring that is genuinely continuous, not interrupted in the field. Risk assessments specific to the actual task, not inherited from a previous job on the same equipment. A topman watching the monitor throughout, not just present at the start. An issuer who returns before work resumes after any break, not one who assumes conditions are the same as they were left.

Where minimum isolation cannot be achieved, the same structured ALARP process applies as on any other permit — a documented, defensible case for why the residual risk is tolerable, not a pragmatic compromise made under time pressure. How isolation should be physically verified rather than assumed is covered in detail in Lockout Tagout and Permit-to-Work: Where Isolation Control Fails. Key concepts and definitions are in the Permit-to-Work Reference Guide.

The consistent thread across confined space incidents is not a single missed step — it is the assumption that the permit was the hard part and the rest was straightforward. In practice, the permit is only the record. The work is everything that happened before it was signed, and everything the issuer stays responsible for until the space is handed back.
